PIPE HAULING
SOUTH SUMATERA – WEST JAVA
GAS PIPELINE PROJECT PHASE II – OFFSHORE
(Learning & Sharing)
INTRODUCTION
Concrete coating pipe is developed to provide:
- Sub sea stability (negative buoyancy)
- Prevention of damage (mechanical damage)
- No trenching is required
- Less steel is required
- Logistic activities for SSWJ II Offshore would be effective and efficient.
- Best Preparation of Man Power and Equipment.
- Best support for the construction / installation activity both at near shore and offshore construction areas.
- Handling of coated pipes would be in best management at coating plant - Bintan and transportation to construction site.
MAN POWER
QA/QC Engineer :
- to inspect Coated pipes by visual inspection
- to collect and record QC documents
HSE Officer :
- to asist the Bintan Coordinantor in maintaining the activity of the transportation in order to meet the HSE requirements.
Logistic Officer :
- to coordinate and monitor the Fabrication of Coating Pipe schedule
- to report to the Procurement and Project Manager and Construction Manager regarding the overall Fabrication progress and Transportation to construction areas
- to coordinate barge load out in order to meet the pipelay schedule
- to communicate with the Laying Barge regarding the offshore position
- to supervise the loading of the pipes
- to coordinate barge load out in order to meet the pipelay schedule
- to communicate with the Laying Barge regarding the offshore position
- to supervise the loading of the pipes to report to the Bintan Operational Coordinator regarding all of the barging activity and progress
OPERATIONAL OVERVIEW
- Loading operations at coaters stock pile
- Trucking to wharfside
- Pre-loading survey
- Tallying operations
- HSE/OHSI Briefings
- Loading operations at wharfside
- Stevedoring at wharfside
- Lashing,securing and dunnaging onboard barges
- Barging operations
WORK FLOW
LOADING OPERATORS @ COATERS STOCKPILE

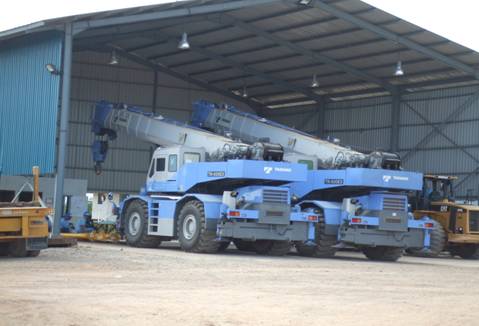

- 2 units of 50T hydraulic boom cranes with crane operators
- 2 sets of stevedores
- 1 foreman
- 6 trucks shunting cargo between stockpile area and wharfside, each truck carrying 3 pipes
MATERIALS & EQUIPMENTS
- All materials used to secure and lash the cargo are certified and all certificates are to be issued
- Loading equipment also to be inspected and certified prior to each load out. All certificates are to be valid or have to be renewed.
- 1 X 125T Wharfside Crane
- 2 X 50T Yard Crane
- Spreader bars @ 22T
- Lashing wires @ 20mm
- Turnbuckles @ 17T
- Shackles @ 17T
- Wire clips @ 6T
- Tarpauline
- Dunnage
- Rubber hose
- Rubber tubes
- Lifting hooks @ 12T
- Lifting belts @ 20T
SURVEYORS
- All pre-loading, On-hire, lashing & securing surveys to be carried out by registered independent surveyors.
HSE / OHSI
- All safety procedures to be scrutinised and monitored by fully certified HSE personnel.
- Ensuring all PPE in place and maintained.
TUG & BARGES
- Various Tug & Barge sizes to be utilized.
- All Tug & Barges have valid registration certificates and class certification.

ONSHORE / NEARSHORES BARGES
Barges for transporting to onshore/nearshore:
- Hafar 218
- Hafar 231
- ADMI
- DMB 8
DMB 88 Lay Barge
OFFSHORE BARGES
Barge for transporting to Offshore:
- CSF 2303
- CSF 2301
- CSF 2302
- CSF 2501
- MANN 2101
- MANN 2701
- CSF 2702
PLB 132 Lay Barge

STOWAGE PLAN
STOWAGE PLAN (Lashing & Cover)
COMMUNICATION SYSTEM
